Level of Engagement: Communicate
Construction Update on May 4, 2026: Thank you for your patience during Phase 2 of the Bluemont Junction Trail Milling and Repaving project. As of Monday, May 4, this project is complete! The work improved conditions along the Bluemont Junction and Four Mile Run Trails as well as key connection points in the area, including a pedestrian bridge.
Construction Update as of April 30, 2026: Phase 2 of the Bluemont Junction Trail Milling and Repaving project is nearing completion and is expected to be done by mid-May (weather permitting). This project improves the Bluemont Junction and Four Mile Run Trails as well as key connection points.
The remaining work includes the welding and painting of Bluemont Junction Trail Bridge #2, which will require the bridge to be closed to the public. While community members can expect periodic closures and detour signage, the bridge will be open after work hours and on weekends. The bridge will also be open all day on May 6 for National Bike & Roll to School Day.
While this work continues, trail segments may be blocked-off with signage. Please refer to the project webpage for the latest updates as work may be done earlier. We will notify the community when work is complete.
Projected Construction Update as of April 13, 2026
- Asphalting complete for all phases of 2, 3A, 3B. Bridge planks and painting to be completed along with the final grading along the trail mid-end of April 2026.
- Project areas 1A & 1B is in progress with an anticipated completion of the asphalt and the pedestrian crossing mid-end of April 2026.
Projected Construction Update as of Feb. 20, 2026
- Project Area 1A: Pedestrian crossing is installed. In progress with an anticipated competition of the asphalt and the pedestrian crossing mid-April 2026.
- Project Area 1B: Concrete is done. In progress with an anticipated competition of the asphalt and the pedestrian crossing mid-April 2026.
- Project Area 2: Milling, repaving, and restriping is complete. The pedestrian bridge repair and improvements remain.
- Project 3A: Milling, repaving, and restriping is complete. The bike repair station and soil backfill is in progress.
- Project Area 3B: Milling, repaving, and restriping is complete. The soil backfill is in progress.
Projected Construction Update as of Jan. 16, 2026
- Asphalting complete for all phases of 2, 3A, 3B.
- Project areas 1A & 1B is in progress and dependent on the weather.
- Pedestrian crossing work is in progress and dependent on the weather.

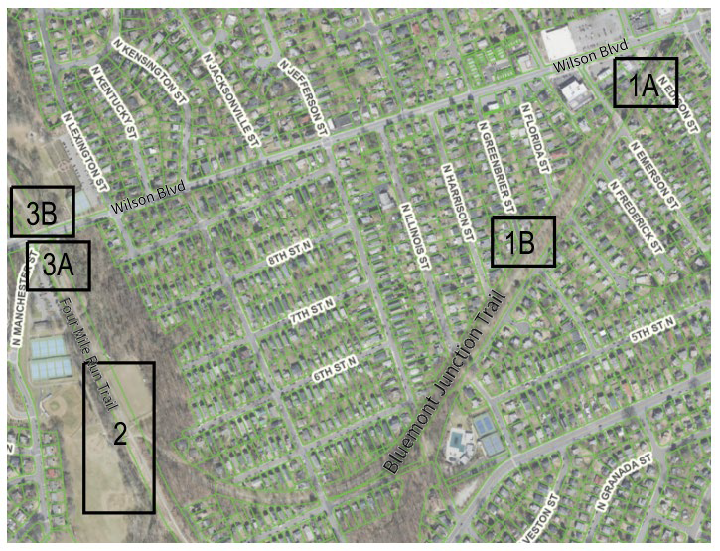

Schedule:
Phase II began on November 17, 2025. The work included in the scope of this project includes:

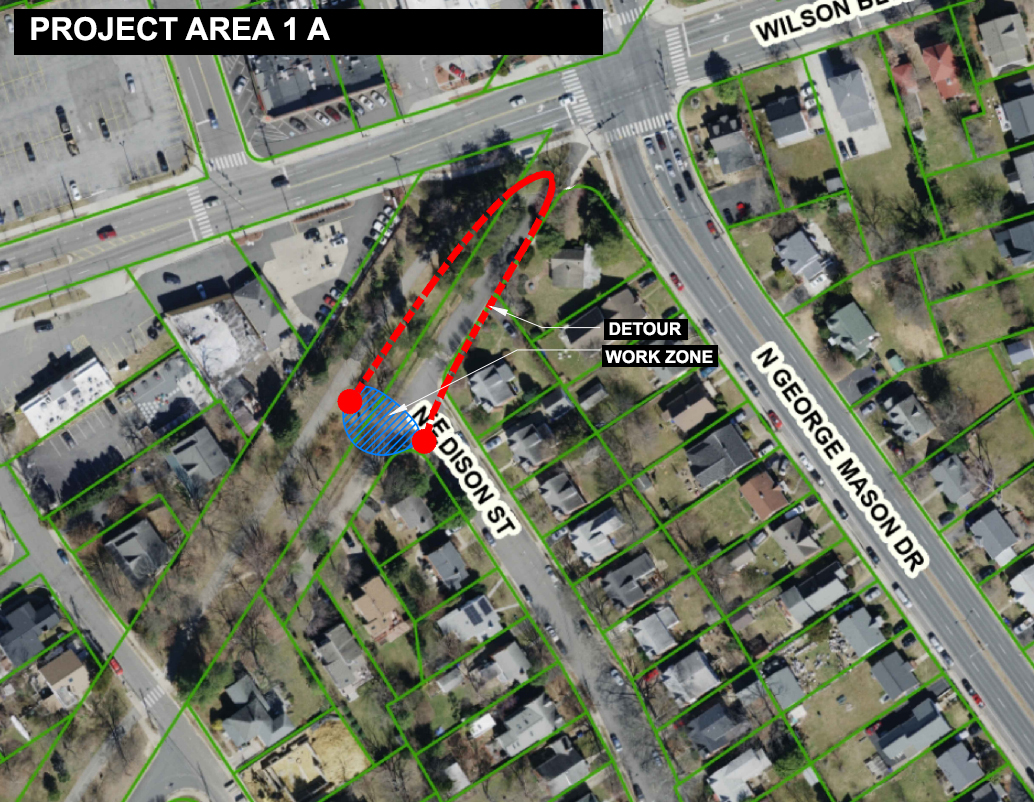

- Project Area 1A: Milling and repaving the trail's concrete is done. Asphalt milling and repaving will be completed next.
- Pedestrian crossing will be installed by December 12, but this will not affect the trail.
- Project Area 1B: Milling and repaving the trail's concrete is done. Asphalt milling and repaving will be completed next.

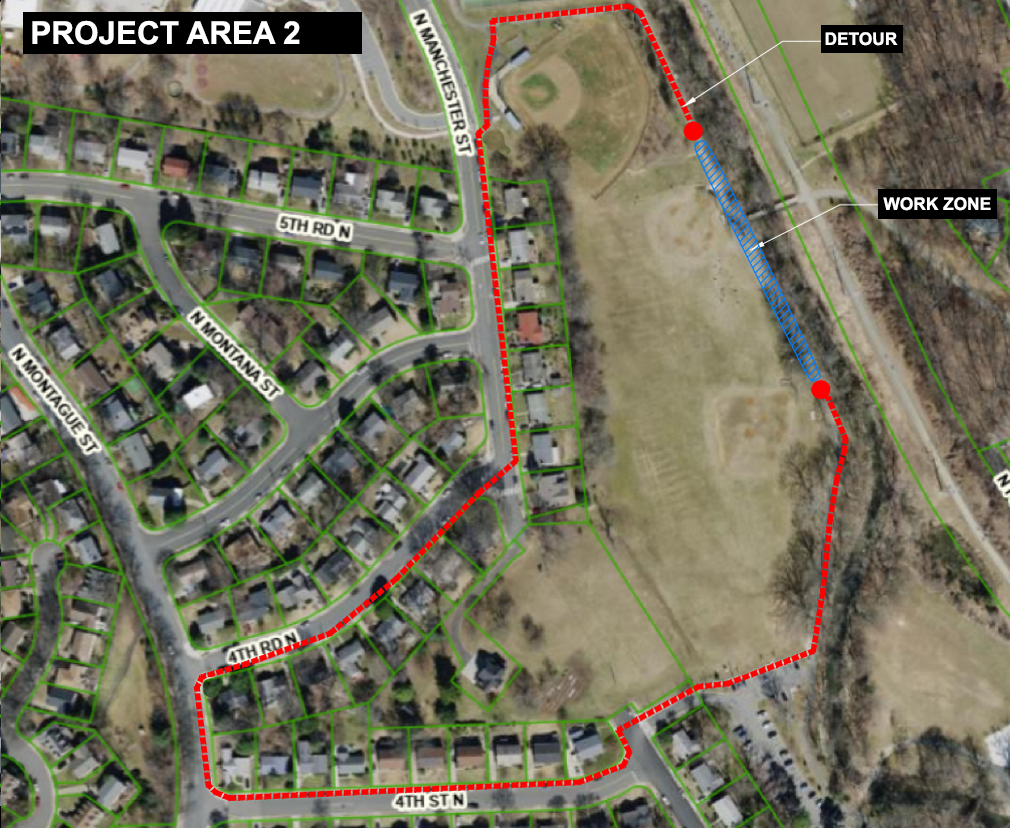

- Project Area 2: Milling and repaving is done. Restriping will be completed next.
- Pedestrian bridge repairs and improvements will take place at a later date, likely in early 2026.
- Project 3A: Milling and repaving work is done. Restriping will be completed next.
- Installation of bike repair station will be completed by December 19.
- Project Area 3B: Milling and repaving work is done. Restriping will be completed next.
