Lacey Woods Park Renovation

Construction

Location

1200 N. George Mason Drive, Arlington, VA 22205  View Map

Google Map

Status

Construction

Pre-Construction meeting held on Nov. 13, 2025. Notice to Proceed (NTP) issued for construction to begin on January 26, 2026. Construction is estimated to take one year.

About the Project

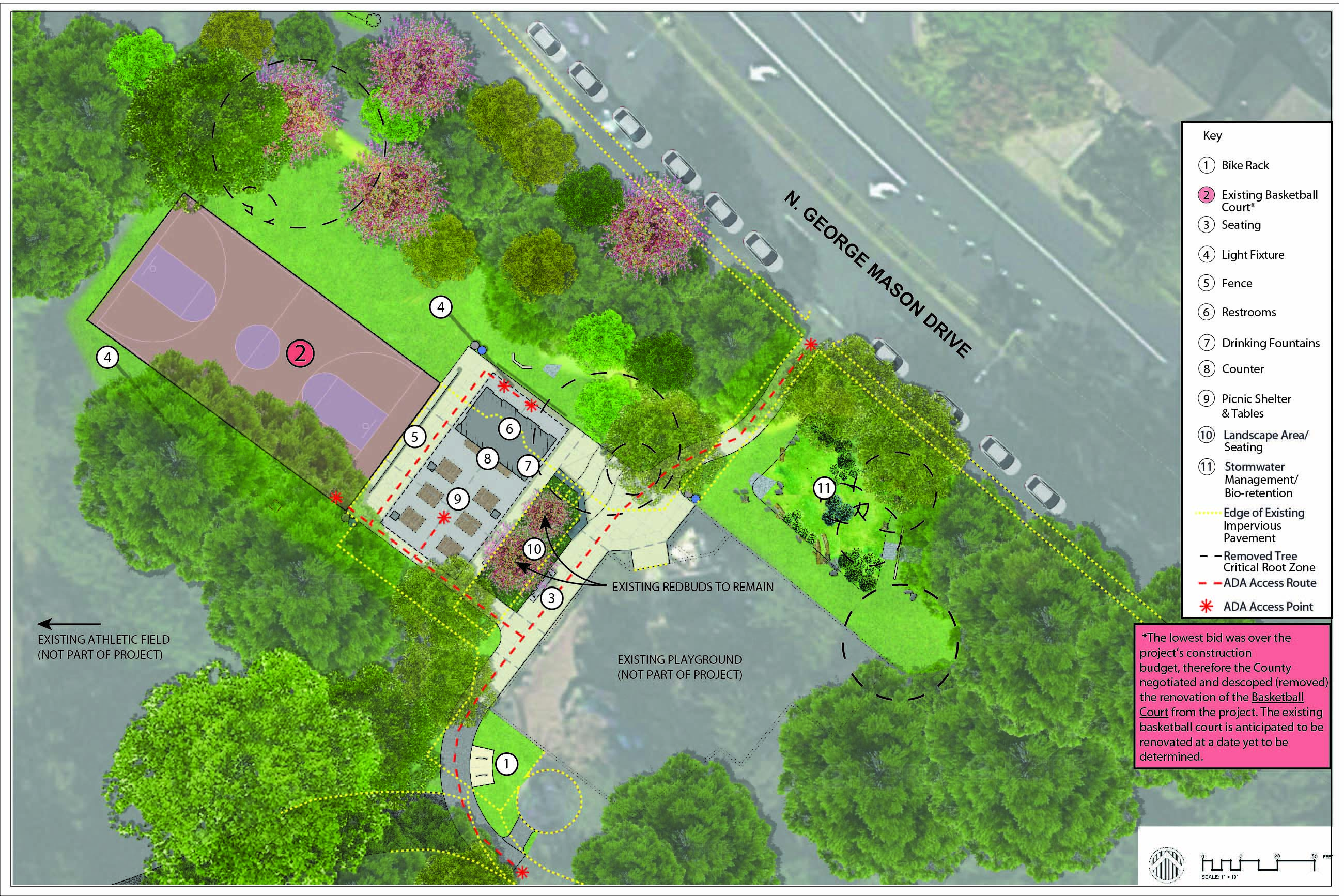

This Parks Maintenance Capital project will renovate the northern portion of Lacey Woods Park. The project scope includes the restrooms and picnic shelter, basketball court lighting, site furnishings, site circulation, ADA improvements, limited fencing, stormwater management, drainage, and landscaping. The existing playground is not included in this renovation phase. It should be noted that the original scope of the project included renovation of the basketball court surface, court fencing, and basketball hoops; however, due to construction costs coming in higher than expected these items have been deferred to a later date.

Project Goals:

  • Renovate restrooms and picnic shelter
  • Improve basketball court lighting
  • Add site furnishings
  • Improve site circulation
  • Provide ADA improvements
  • Improve drainage

About the Process

Click the drop downs below to explore the details and resources throughout the project process.

Fall 2023 - Feedback on Existing Conditions and Use

Level of Engagement: Involve

The community shared input on 2 draft concepts through an online questionnaire. The questionnaire opened on October 5, 2023, and closed on October 26, 2023. Review community comments through this first engagement summary. Raw data from this engagement opportunity can be found here.

Spring 2024 - Final Engagement

Final Engagement Summary: From April 8 to April 26, 2024, staff gathered feedback on the final draft design concept. Read the responses from the community.

Fall 2025 - County Board Action

Level of Engagement- Communicate

Board has approved construction contract.

Winter 2026 - Construction Begins

Level of Engagement- Communicate

Pre-Construction meeting held on Nov. 13, 2025. Notice to Proceed (NTP) has been issued.

Construction will begin the week of March 9, 2026, and is expected to take one full year.

Winter 2026/2027 (Projected) - Construction Ends

Construction is anticipated to be complete one year after beginning.
